How to Handle Legacy Underground Storage Tank Discovery

legacy underground storage tank discovery demolition, UST discovery during industrial decommissioning, underground tank remediation plant teardown, buried storage tank handling facility demolition, unexpected UST industrial site decommissioning

EPA data on underground storage tank releases documents 581,000 confirmed releases from regulated underground storage tanks, with approximately 54,000 sites still awaiting cleanup—a backlog that reflects both the prevalence of legacy USTs and the complexity of cleaning up after them. The EPA's own database tracks 542,000 currently regulated USTs, but regulatory tracking covers only a fraction of what was actually installed over decades of industrial operation before environmental record-keeping requirements existed. On a brownfield industrial plant built between the 1940s and 1980s, unrecorded USTs are not a remote possibility. They are an actuarial probability. The question is not whether a legacy underground storage tank discovery demolition project will encounter one, but whether the project schedule has been designed to absorb that discovery without collapsing.

The average cleanup cost for a leaking underground storage tank exceeds $1 billion annually across the national LUST program, with individual site remediation costs averaging $116 per day in ongoing expenses once a release is confirmed, according to EPA's LUST Cleanup Cost Study. Those costs begin accruing from the moment of discovery—or from the moment of regulatory notification, which must occur within specific timeframes after discovery regardless of whether the project team believes the release is significant. Unexpected UST industrial site decommissioning response failures are almost always speed failures: the project team does not notify promptly, does not characterize quickly, and does not adjust the schedule immediately. Each delay compounds the regulatory and financial exposure.

The GeoForward analysis of UST soil contamination describes the contamination profile that most UST discoveries present: a plume of petroleum hydrocarbons or solvent contamination in the soil and groundwater surrounding the tank, with the plume extent unknown at the time of discovery. Before any demolition work can continue in the vicinity of the discovery, the plume extent must be characterized. That characterization process—additional soil borings, groundwater sampling, laboratory analysis—takes weeks to months depending on the site conditions and regulatory requirements.

The Discovery Response Framework

Think of a UST discovery as an unscheduled rest inserted into the middle of a performance. The conductor cannot simply ignore it and let the musicians continue playing—the acoustic space has changed, the score no longer matches the hall conditions, and continuing without acknowledging the change produces dissonance rather than music. UST discovery during industrial decommissioning inserts a mandatory rest into the demolition score. The response framework determines how long that rest lasts and whether adjacent voices can continue playing while the discovery voice resolves.

The discovery response framework has five sequential steps, each with time requirements that must be added to the project schedule immediately upon discovery.

Step 1, work stoppage and site assessment: all excavation and demolition activities in the vicinity of the discovery must be halted immediately. The vicinity boundary is not a circle drawn by the project team—it is defined by the potential plume extent, which at the moment of discovery is unknown. A conservative initial boundary of 50 meters in all directions around the visible tank is a standard starting point, subject to revision after initial soil and groundwater assessment.

Step 2, regulatory notification: CERCLA Section 103 notification requirements impose reporting timelines that begin at the moment of discovery. State UST programs impose additional notification requirements with state-specific timelines—commonly 24 hours for initial notification and 20-30 days for a written report. The EPA's LUST cleanup process guidance outlines the federal regulatory process that follows notification. The project team must have the notification contacts, forms, and procedures ready before work begins—not assembled after a discovery occurs.

Step 3, characterization scope and timeline: the regulatory agency reviewing the notification will require a site assessment to characterize the release. That assessment scope is partially defined by regulatory guidance and partially negotiated with the agency reviewer. Understanding the required scope before discovery—by reviewing the state UST program's assessment requirements during project planning—allows the project team to prepare a characterization work plan that is ready to execute upon regulatory approval, rather than written from scratch after notification.

Step 4, schedule impact assessment: while characterization is proceeding, the project manager must assess the impact of the work stoppage on adjacent zones. Can demolition continue in zones outside the work stoppage boundary? Do any logistics corridors pass through the stoppage boundary? Are any crane paths or material staging areas within the affected area? The schedule impact is not limited to the discovery zone—it extends to every activity that depends on access through or adjacent to that zone.

Step 5, remediation scope integration: once characterization is complete, the regulatory agency will approve a remediation approach. That approach—whether tank removal and soil excavation, in-situ treatment, or monitored natural attenuation—must be integrated into the decommissioning schedule as a new voice on the score. The remediation timeline becomes a constraint on when structural demolition in the affected zone can proceed.

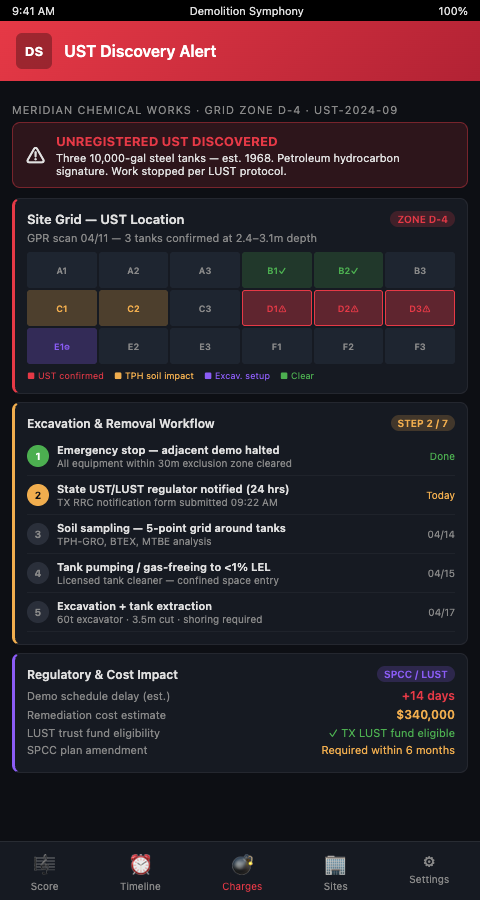

Demolition Symphony Planner UST discovery response interface showing notification timeline, characterization work plan, work stoppage boundary, adjacent zone impact assessment, and remediation phase integration on the decommissioning schedule

Managing UST Discovery in Demolition Symphony Planner

Demolition Symphony Planner includes a UST discovery event workflow that activates when a project manager logs a discovery. The workflow immediately inserts a work stoppage boundary on the site plan, identifies all scheduled activities within or adjacent to that boundary, and calculates the schedule impact of suspending those activities. The project manager sees the cascade effect in real time before any field communication is made, enabling an informed conversation with the contractor about which work can continue, which must pause, and for how long.

The discovery workflow generates a regulatory notification checklist automatically: federal CERCLA reporting requirements, state UST program notification requirements (populated based on the project's state location), and local fire authority notification if the release involves flammable materials. The checklist includes contact information, required documentation, and notification deadlines—ensuring that the project team meets regulatory timelines even during the operational pressure of an active discovery response.

Soil remediation scheduling is the primary planning analog for UST discovery integration: a discovery event is an unplanned addition of a soil remediation voice to the score. Demolition Symphony Planner handles it by inserting the remediation voice for the discovery zone, populating it with estimated durations based on contaminant type and regulatory framework, and recalculating the earliest completion date for structural demolition in that zone. The estimate is rough at first; it is refined as characterization results and regulatory decisions clarify the remediation scope.

GeoForward's UST abandonment and removal guidance covers the physical process of tank closure: contents pumping, cleaning, assessment of tank condition, and either removal or abandonment-in-place depending on depth, access, and structural condition. For decommissioning projects, removal is almost always preferred over abandonment-in-place, because an abandoned tank becomes a future liability for the site's eventual redevelopment. The DLA's environmental guide for fuel facilities provides additional technical requirements for UST removal procedures applicable to industrial sites.

The EPA's UST FAQ clarifies the regulatory status of petroleum USTs and the closure requirements that apply regardless of the tank's operational history. A UST that has been out of service for decades is still subject to closure requirements—it was not grandfathered by age.

Advanced Tactics for Pre-Discovery Planning

The most effective UST discovery response is executed by a team that has already rehearsed it. Pre-project UST risk assessment—reviewing historical aerial photography, Sanborn fire insurance maps, facility records, and Phase I ESA findings—identifies the probability and likely locations of unrecorded USTs before excavation begins. High-probability areas can be designated as UST alert zones on the project score, triggering additional protocols when excavation enters those areas: slower excavation pace, on-site environmental technician presence, and soil screening at each excavation lift.

Controlled burn scheduling must account for the possibility of UST discoveries in burn zones: structures proposed for controlled burning in areas with UST probability should complete a subsurface investigation before the burn permit application is submitted. A UST discovery after a burn permit is approved—but before the burn—requires permit modification and potential delay while regulators assess whether the burn can proceed adjacent to an active remediation site.

Cross-niche relevance: the utility line investigation discipline that precedes bridge demolition to identify buried utility conflicts is the surface analog to UST investigation for industrial sites. Both involve locating buried infrastructure that is not accurately mapped in existing records, using a combination of historical records research and geophysical survey. In both cases, the cost of investigation before demolition is a fraction of the cost of discovery during demolition.

Buried storage tank handling facility demolition planning should include a UST contingency budget—a schedule float reserve and cost reserve specifically designated for UST discovery response. Projects that treat UST discovery as a zero-probability event and build no reserve will transfer the discovery cost directly to project contingency, often exhausting it on the first discovery and leaving no buffer for subsequent ones. The EPA's 54,000-site cleanup backlog is evidence that UST discoveries are not rare; they are the expected outcome on most brownfield industrial decommissioning projects.

Ready to build UST discovery response into your decommissioning plan? Map your UST probability zones, pre-position your notification procedures, and load your state regulatory requirements into Demolition Symphony Planner so that a discovery triggers an immediate, structured response rather than a scheduling crisis. Start your UST contingency planning today and get notification procedures, characterization protocols, and schedule impact workflows loaded before the first excavator opens the ground.
